Appendix 3
06-Apr-2001 17:23

ASTEC Financial Report Phase 2

Costs compared to contract for Phase 2 (1999-2000).

The amount of contributions from the parts follow the planned proportions according to the ASTEC agreement for 1999-2000. The total amount for 1999 were 8% lower than calculated, this has been compensated for by increased activity 2000. Ericsson Utvecklings AB has contributed with 3200 kkr in cash; all other industry contribution were emoluments paid in kind. A special funding of 250 kkr was received from NUTEK for the Competence center day and evaluation during 2000, this has not been included in contract money but otherwise it is included below.

Part Contract % Cost %
Industry 12200000 36 12512295 37
Uppsala Universitet 9530000 28 9245489 27
NUTEK 12000000 36 12071660 36
Sum 33730000 100 33829443 100

Contributions by ASTEC industrial parties compared to the contract.

Industry Contract (SEK) Cost Changes (%)
ABB Autom. Prod. AB 170000 327400 93
Ericsson Utvecklings AB 4100000 4910000 20
IAR Systems AB 3600000 4258763 18
Mecel AB 900000 824601 -8
Prover Technology AB 720000 515281 -28
UPAAL Sweden AB 300000 0 -100
Telelogic AB 780000 168750 -78
Telia Validation AB 1350000 1350000 0
Volcano Com. Tech. AB 100000 0 -100
Volvo Tech. Dev. AB 180000 157500 -13
Sum 12200000 12512295 3














Proportion of costs on ASTEC programme areas compared to budget.

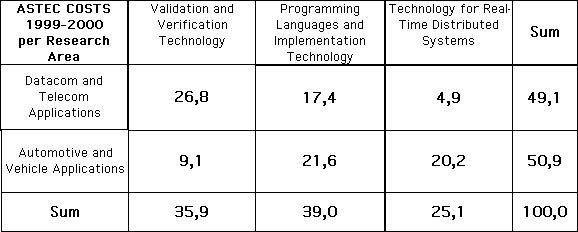

Costs per research area 1999-2000

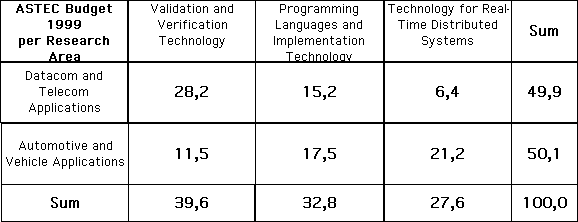

Budget per research area

Management, administration and network activity costs

The cost for mangement is not fully visible since there is no compensation for the part carried out by the board. The director´s time is mainly a part of Uppsala Universitys contribution. The cost for management and administration has been as budgeted for 1999 and slightly lower than planned during 2000 due to possibilities for coordination with other tasks at the University and reimbursement by NUTEK for costs at Competence center day 2000 and evaluation. The cost for 1999-2000 were 2362 kkr including support to network activities such as conference NWPT 99, Competencecenter day 2000, evaluation of both ASTEC and SUMMIT, seminars, project leader meetings and visiting scientists.

Funds 2000-12-31 and the planned use of these

At the start of Phase 2 (1998-12-31) were 538 756 SEK available. At the end of the phase were 4 623 503 SEK available. However of these funds were 3 MSEK obtained during dec 2000 for phase 3, and 750 627 SEK are reserved for phase 2 costs. The remaining 872 876 SEK is planned to be used during phase 3. This has been discussed with NUTEK during the planing of Phase 3 and at board meetings.

Remaining funds 2000-12-31
Within ASTEC 3717096
within projects 906407
Sum 4623503
Reserved funds
For Phase 3 3000000
For projekts 290000
Within projekts 436106
Evaluation of SUMMIT 24521
Advance from contributors 2000-12-31 872876
SUM 4623503
